Free Architecture Budget Report Template

Architecture Budget Report

I. Executive Summary

This Architecture Budget Report provides a comprehensive financial overview of our ongoing commercial building project. The purpose of this report is to ensure that all financial aspects are monitored and managed effectively to maintain budget compliance and project success.

Key Financial Highlights

  1. Total project budget: $1,000,000

  2. Total expenditures to date: $450,000

  3. Remaining budget: $550,000

  4. Key cost: Design and Planning, Permit and Approval, Construction, Materials and Supplies, Labor

II. Project Description

We are undertaking a comprehensive architectural project located at [Project Location]. The project scope includes schematic design, design development, construction documents, and construction administration. The timeline for the project is as follows:

  • Schematic Design: 30 days (completed)

  • Design Development: 60 days (ongoing)

  • Construction Documents: 90 days

  • Construction Administration: Throughout construction period, at 180 days

III. Budget Overview

The total estimated budget for the project is $1,000,000. Below is a table summarizing the major cost categories:

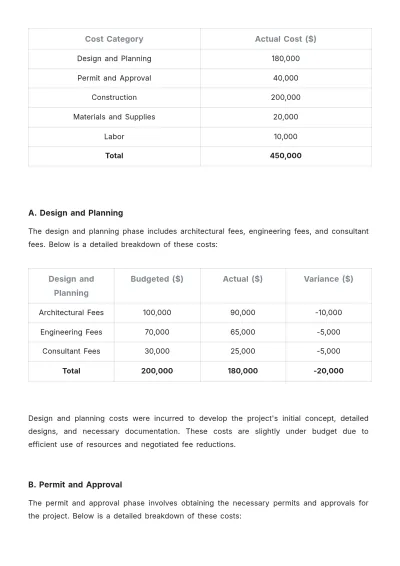

Cost Category

Actual Cost ($)

Design and Planning

180,000

Permit and Approval

40,000

Construction

200,000

Materials and Supplies

20,000

Labor

10,000

Total

450,000

A. Design and Planning

The design and planning phase includes architectural fees, engineering fees, and consultant fees. Below is a detailed breakdown of these costs:

Design and Planning

Budgeted ($)

Actual ($)

Variance ($)

Architectural Fees

100,000

90,000

-10,000

Engineering Fees

70,000

65,000

-5,000

Consultant Fees

30,000

25,000

-5,000

Total

200,000

180,000

-20,000

Design and planning costs were incurred to develop the project's initial concept, detailed designs, and necessary documentation. These costs are slightly under budget due to efficient use of resources and negotiated fee reductions.

B. Permit and Approval

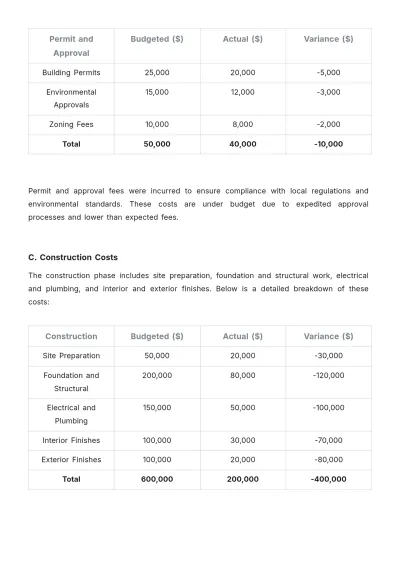

The permit and approval phase involves obtaining the necessary permits and approvals for the project. Below is a detailed breakdown of these costs:

Permit and Approval

Budgeted ($)

Actual ($)

Variance ($)

Building Permits

25,000

20,000

-5,000

Environmental Approvals

15,000

12,000

-3,000

Zoning Fees

10,000

8,000

-2,000

Total

50,000

40,000

-10,000

Permit and approval fees were incurred to ensure compliance with local regulations and environmental standards. These costs are under budget due to expedited approval processes and lower than expected fees.

C. Construction Costs

The construction phase includes site preparation, foundation and structural work, electrical and plumbing, and interior and exterior finishes. Below is a detailed breakdown of these costs:

Construction

Budgeted ($)

Actual ($)

Variance ($)

Site Preparation

50,000

20,000

-30,000

Foundation and Structural

200,000

80,000

-120,000

Electrical and Plumbing

150,000

50,000

-100,000

Interior Finishes

100,000

30,000

-70,000

Exterior Finishes

100,000

20,000

-80,000

Total

600,000

200,000

-400,000

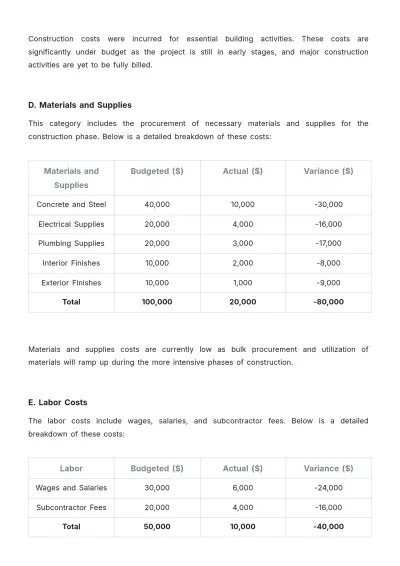

Construction costs were incurred for essential building activities. These costs are significantly under budget as the project is still in early stages, and major construction activities are yet to be fully billed.

D. Materials and Supplies

This category includes the procurement of necessary materials and supplies for the construction phase. Below is a detailed breakdown of these costs:

Materials and Supplies

Budgeted ($)

Actual ($)

Variance ($)

Concrete and Steel

40,000

10,000

-30,000

Electrical Supplies

20,000

4,000

-16,000

Plumbing Supplies

20,000

3,000

-17,000

Interior Finishes

10,000

2,000

-8,000

Exterior Finishes

10,000

1,000

-9,000

Total

100,000

20,000

-80,000

Materials and supplies costs are currently low as bulk procurement and utilization of materials will ramp up during the more intensive phases of construction.

E. Labor Costs

The labor costs include wages, salaries, and subcontractor fees. Below is a detailed breakdown of these costs:

Labor

Budgeted ($)

Actual ($)

Variance ($)

Wages and Salaries

30,000

6,000

-24,000

Subcontractor Fees

20,000

4,000

-16,000

Total

50,000

10,000

-40,000

Labor costs are currently under budget as the project is in the initial stages, with significant labor costs expected to accrue during the more intensive phases of construction.

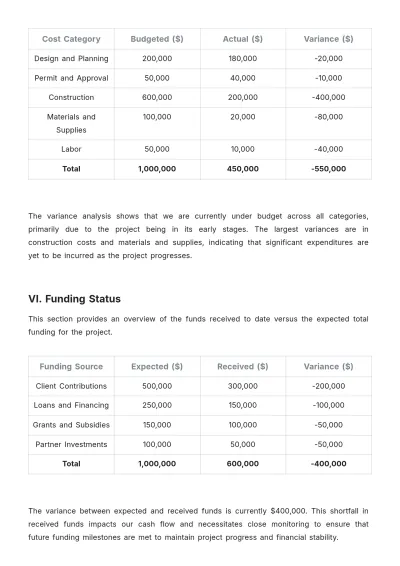

V. Variance Analysis

This section provides a comparison of the budgeted costs versus the actual costs incurred to date, identifying any variances and their implications for the project.

Cost Category

Budgeted ($)

Actual ($)

Variance ($)

Design and Planning

200,000

180,000

-20,000

Permit and Approval

50,000

40,000

-10,000

Construction

600,000

200,000

-400,000

Materials and Supplies

100,000

20,000

-80,000

Labor

50,000

10,000

-40,000

Total

1,000,000

450,000

-550,000

The variance analysis shows that we are currently under budget across all categories, primarily due to the project being in its early stages. The largest variances are in construction costs and materials and supplies, indicating that significant expenditures are yet to be incurred as the project progresses.

VI. Funding Status

This section provides an overview of the funds received to date versus the expected total funding for the project.

Funding Source

Expected ($)

Received ($)

Variance ($)

Client Contributions

500,000

300,000

-200,000

Loans and Financing

250,000

150,000

-100,000

Grants and Subsidies

150,000

100,000

-50,000

Partner Investments

100,000

50,000

-50,000

Total

1,000,000

600,000

-400,000

The variance between expected and received funds is currently $400,000. This shortfall in received funds impacts our cash flow and necessitates close monitoring to ensure that future funding milestones are met to maintain project progress and financial stability.

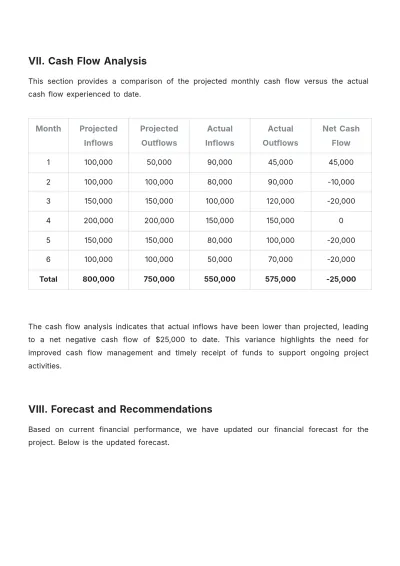

VII. Cash Flow Analysis

This section provides a comparison of the projected monthly cash flow versus the actual cash flow experienced to date.

Month

Projected Inflows

Projected Outflows

Actual Inflows

Actual Outflows

Net Cash Flow

1

100,000

50,000

90,000

45,000

45,000

2

100,000

100,000

80,000

90,000

-10,000

3

150,000

150,000

100,000

120,000

-20,000

4

200,000

200,000

150,000

150,000

0

5

150,000

150,000

80,000

100,000

-20,000

6

100,000

100,000

50,000

70,000

-20,000

Total

800,000

750,000

550,000

575,000

-25,000

The cash flow analysis indicates that actual inflows have been lower than projected, leading to a net negative cash flow of $25,000 to date. This variance highlights the need for improved cash flow management and timely receipt of funds to support ongoing project activities.

VIII. Forecast and Recommendations

Based on current financial performance, we have updated our financial forecast for the project. Below is the updated forecast.

Year

Original Revenue Forecast

Updated Revenue Forecast

Original Expense Forecast

Updated Expense Forecast

Original Net Profit

Updated Net
Profit

1

1,200

1,150

1,000

1,050

200

100

2

1,300

1,250

1,100

1,150

200

100

3

1,400

1,350

1,200

1,250

200

100

Total

3,900

3,750

3,300

3,450

600

300

Note: in thousands

Recommendations

  1. Enhance Funding Efforts: Accelerate the collection of expected funds and explore additional funding sources to cover the shortfall.

  2. Cost Control Measures: Implement stricter cost control measures to manage and reduce expenses.

  3. Cash Flow Management: Improve cash flow management by closely monitoring inflows and outflows and adjusting the budget accordingly.

  4. Regular Financial Reviews: Conduct regular financial reviews to ensure the project remains on track and within budget.

These adjustments and recommendations will help ensure the project's financial health and successful completion.

Architecture TemplatesTemplate.net
